• SIGNA™ Hero 3.0T Service Methods
  • 5852800-8EN Revision 1.0
  • Object ID: 00000018WIA30C9FA40GYZ
  • Topic ID: id_2016463 Version: 4.0
  • Date: Nov 2, 2021 1:14:23 PM

Running ICW Installation Mode

The Installation and Calibration Wizard provides an interface to navigate through required system procedures, checks, and calibrations.

Prerequisites

Personnel requirements
Required personsPreliminary requirementsProcedureFinalization
1-Varies-
Required conditions
Make sure all customer-purchased options are installed before running ICW. Any options added after running ICW will not be displayed.
A service key is required to launch the Installation and Calibration Wizard.
Safety

Before working in any GE Healthcare MR suite or performing any GE Healthcare service procedure, you must:

  • Have read and understood all hazard conditions and safety requirements in the latest revision of the GE Healthcare MR Service Safety Manual (5452735).
  • Have successfully completed all relevant GE Healthcare Environmental Health and Safety (EHS) courses (or for non-GE employees, equivalent workplace training courses).
  • Comply with all site-specific training and workplace safety requirements.

If you have any safety concerns at any time, do not begin work or immediately stop work and move to a safe location. Immediately contact your supervisor or site safety officer for instructions on how to proceed.

About this task

ICW installation mode is used for new installations and upgrades.

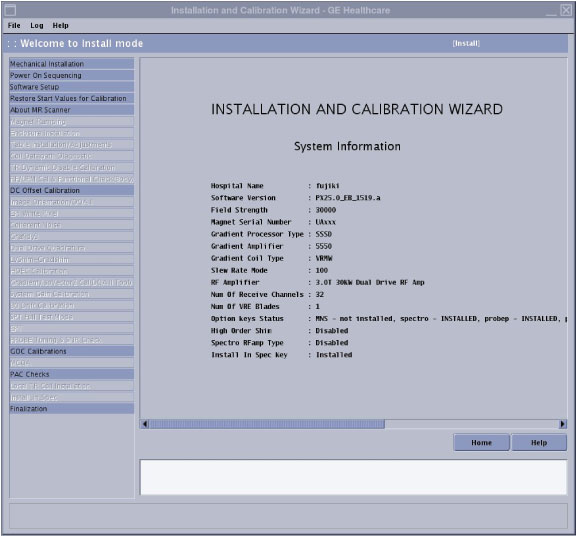

Figure 1. ICW Install mode screen

  • The left pane lists all tasks required to complete the installation.
  • Tasks must generally be completed in order, from top to bottom (tasks with prerequisites are grayed out until all prerequisites are completed). Non-grayed out tasks may be completed in any order or in parallel.
  • After a task is completed, click Check Status in the right pane. Completed tasks turn blue; failed tasks turn red.
  • ICW remains in installation mode until all tasks are successfully completed.
Note:
When running ICW, the calibration tools are launched and finalized from within the ICW interface.

Figure 2. ICW calibration tool interface
Note: (For software versions 29.0 and later)
  • Software version 29.0 introduces forced password changes on all user accounts to comply with minimum mandated security requirements for GE equipment.
  • Password changes are mandated on two instances:
    • When booting the software for the first time.
    • When rebooting the system after completion of Install In Spec.

When running these tools within ICW, some of the finalization tasks such as Doing a TPS reset or Saving information will be automatically completed by ICW.

Procedure

  1. Before opening ICW for the first time, make sure all options purchased by the customer are installed.
    Note:

    The option key check is only done the first time the tool is used. Any change to the option key status after ICW has started will not be displayed.

  2. From the Common Service Desktop select Calibrations > Installation and Calibration Wizard.
  3. Use the following tables as a reference to identify what tasks are needed to complete each procedure within ICW.
    Note:

    Relaunching a completed task in ICW displays a dialog showing prerequisite tasks. You may want to rerun the prerequisites listed before rerunning the selected task.

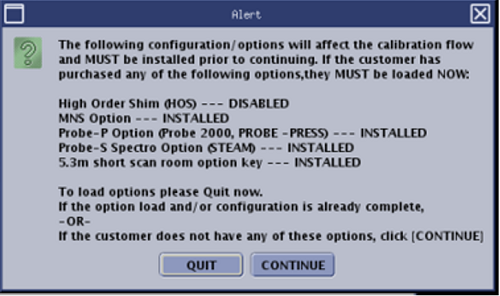

    Figure 3. ICW alert dialog
    ProcedureTasksPersonnel requirements
    Mechanical install hand-off to GE--
    Power on sequencing 1Power on sequencing 1.1 person

    30 minutes

    ICC hose and valve check, and fill coolantICC hose and valve inspection, coolant fill, and coolant leak check.1 person

    90 minutes

    Power on sequencing 2Power on sequencing 2.1 person

    30 minutes

    Emergency stop and off checkSee Checking the Emergency Stop and Off functions.1 person

    45 minutes

    Invoke ICW and check off
    1. When you power up the host computer and see the login screen, click root login.
    2. Log in with the user name: root and password.
      Note: It is possible that the customer changed the default password. If you cannot log in, contact the customer for the correct password.
    3. Logging in as the root user automatically displays the Linux desktop and launches the Guided Install Starter window. Click No to ignore the Guided Install.
    4. Confirm that the service key is installed.
    5. Right-click on the Linux desktop to access the Root Menu and then select Start ICW.

    6. ICW screen shows:

    Mechanical Installation

    Record the start and end dates.

    Power on sequencing

    Answer the following questions:
    • Have you filled chiller and lines with coolant?
    • Is Magnet Monitor power connected to customer source?
    • Have you completed system power on sequentially?
    • Are the coolant leak checks done?
    • Have you completed the E-Stop and E-Off functional checks?

    Software setup

    Answer the following questions:
    -
    About MR scanner

    See Running the About MR Scanner tool.

    Note: Make sure the system parameters and hardware configuration are correct for your system, and edit accordingly in Guided Install (see System and hardware configuration).
    1 person

    5 minutes

    Dock/Table Anchor

    Answer question related to two-part dock/table anchor. See Checking off ICW Dock/Table Anchor items.

    -
    Enclosure removal for ramping and shimming

    Check that the covers are installed correctly and remove only the covers that are necessary for magnet ramping and shimming.

    1. Concealment kit covers
    2. Upper, front, and rear service access panels
    3. Front end bell covers
    4. Rear and inner bridge covers

    For detailed instructions, see Removing and installing the magnet enclosure covers.

    2 people

    60 minutes

    Removing the 1-piece bridgeSee Removing the 1-piece bridge.-
    Mapping fixture setup
    Refer to the Magnet and Cryogens subsystem manual for these tasks:
    • For UA magnets: Magnet and Cryogen Manual for Passively Shimmed Magnets (5495018)
    • For AR magnets: Magnet and Cryogen Manual for 3.0T AR Series Magnets (5881576-8EN)
    -
    Preparations of magnet ramp up-
    STET tool setup-
    Magnet ramping-
    Magnet ramp up cable disconnect-
    Magnet field drift rate check-
    Passive shimming-
    Check off magnet ramping in ICW
    Answer the following questions:
    • Are magnet preramping requirements done?
    • Is the magnet rundown unit functional check done?
    • Is magnet ramping done?
    • Is passive shimming done on this magnet?
    See Checking off ICW Magnet Ramping items.
    -
    Ground resistance checks (for patient table, ISC)See Measuring ground resistance.1 person

    60 minutes

    Installing the 1-piece bridgeReinstall the 1-piece bridge and rear bridge covers after ramping and shimming. See Installing the 1-piece bridge.-
    Table adjustment

    See Doing ICW dockable table adjustments.

    Note:
    • Do not install the cradle top cover for coil data path diagnostics.
    • Power on the system to Applications mode and make sure the TPS reset is successful.
    • Download and open the Alignment Data Sheet Macro (DOC2647017) from the online documentation library to use during table adjustments
    • Do not electronically dock the dockable table until table alignment is complete. Damage to the ODU pins may occur.
    2 people

    4 hours and 20 minutes

    Table functional checkSee Checking the patient table1 person

    60 minutes

    Coil datapath diagnosticSee ICW coil data path diagnostic.1 person

    2 hours

    Set up the total digital imaging (TDI) posterior array (PA) See Setting up Total Digital Imaging (TDI) Posterior Array (PA)1 person

    60 minutes

    Enclosure re-installation after ramping and shimmingReinstall the following covers, as applicable, after ramping and shimming:
    1. Concealment kit covers
    2. Upper, front, and rear service access panels
    3. Front end bell covers
    4. Rear and inner bridge covers

    For detailed instructions, see Removing and installing the magnet enclosure covers and Installing the cable concealment covers.

    -
    Laser light checkSee Checking and aligning the laser light.1 person

    10 minutes

    Body coil air flow checkSee Checking the body coil air flow.1 person

    1 hour and 15 minutes

    TR dynamic disableSee Calibrating transmit/receive dynamic disable.1 person

    3 minutes

    Auto DQA calibrationSee Doing DQA calibration.1 person

    30 minutes (varies)

    Gradient DC offsetSee DC offset adjustment.1 person

    5 minutes

    Coherent noise checkSee Doing the ICW coherent noise check.1 person

    10 minutes

    GrafidySee Calibrating grafidy.1 person

    2 hours

    Auto DQA calibrationSee Doing DQA calibration.1 person

    40 minutes (varies)

    LV shim (grad)See Running LVShim.-
    High order eddy currentSee Calibrating High Order Eddy Current (HOEC).1 person

    60 minutes

    DD quad cal multi locationSee Dual drive quadrature tool.1 person

    45 minutes

    B0 drift testDo Checking B0 Drift. If the test fails, see Calibrating B0 drift.1 person

    90 minutes

    SPTSee System Performance Test (SPT).-
    Probe calibration and SNR check (option)See PROBE/SV calibration and SNR tests.1 person

    1 hour and 30 minutes

    GOC calibrationsSee Doing ICW GOC calibrations.2 people

    3 hours

    MCQARun MCQA for all applicable coils on site. See Coil information.
    Note: As a minimum requirement for ICW MCQA to pass the TDI PA, MCQA must pass.
    -
    PAC checkSee Checking off ICW PAC items.1 person

    45 minutes

    Local TR coil installation (stability test for local TR coil)See Doing the local TR coil Stability test.1 person

    20 minutes

    FinalizationSee ICW finalization.1 person

    45 minutes
