• SIGNA™ Hero 3.0T Service Methods
  • 5852800-8EN Revision 1.0
  • Object ID: 00000018WIA3049C230GYZ
  • Topic ID: id_15667010 Version: 1.11
  • Date: Oct 8, 2021 11:40:21 AM

PHPS 2 Replacement

Prerequisites

Table 1. Personnel requirements
Required personsPreliminary requirementsProcedureFinalization
1Not Applicable60 minutes15 minutes
Table 2. Tools and test equipment
ItemQuantityEffectivityPart numberManufacturer
Standard Tool1---
Table 3. Replacement parts
ItemQuantityEffectivityPart numberManufacturer
PHPS 2 1-

Refer to FRU Manual

-
Table 4. Safety
Table 5. Required conditions
ConditionReferenceEffectivity

System Power must be turned OFF. Refer to LOTO for ISC.

--

Procedure

  1. Open ISC front covers.
  2. Slowly move forward the ICN per following steps.

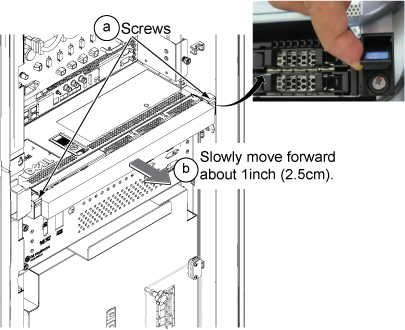

    1. Loosen 2 captive screws under the screw cover
    2. Slowly move forward the ICN about 1inch (2.5cm) not to force the rear cable.
    Figure 1. ICN
  3. At Magnet Room side, remove ICN rear access cover by loosening the screws.
    Figure 2. ICN rear access cover
  4. Remove optical cable of PHPS from access window of ICN.
    Note: The other cables can be removed later from front access.
    Note: If the space is too narrow, ICN can be moved forward since front screws were already loosened.

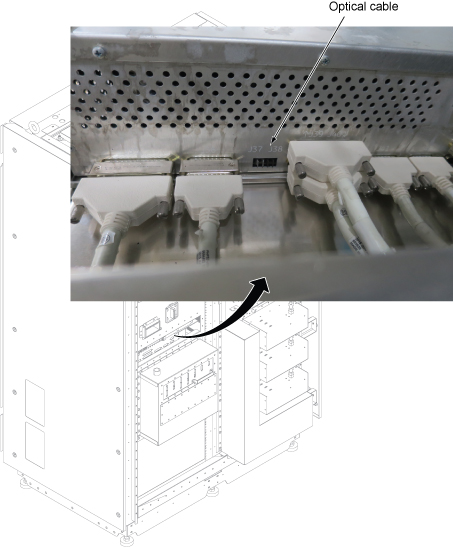

    Figure 3. Optical cable
  5. Perform the following steps.
    1. Disconnect all connectors from PHPS2 front panel.
    2. Loosen 4 screws.
    3. slide out the tray.

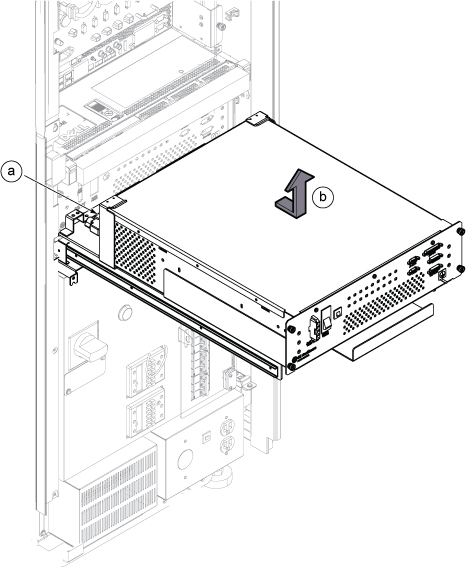

    Figure 4. PHPS 2 Removal 1

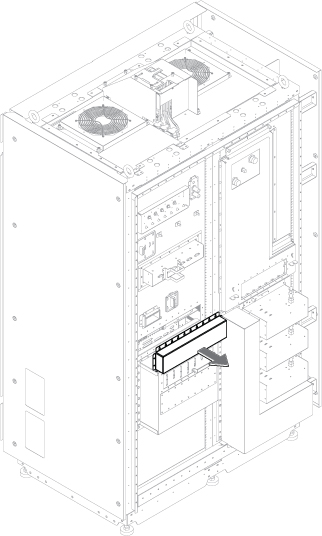

  6. Perform the following steps.
    1. Disconnect all cables from PHPS 2 from rear side.
    2. Slide the PHPS 2 forward and lift up to remove it.

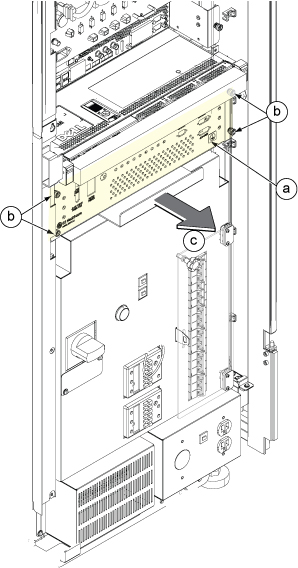

    Figure 5. PHPS 2 Removal 2
  7. Remove the sub-D filters from connectors J35, J36, and J54. Retain the filters for installation on the replacement unit.
  8. Restore PHPS 2 by reverse order of removal.

Finalization

  1. Restore the Power. Refer to Removing LOTO - ISC.
  2. Start up the host computer. Refer to Starting up the host computer
  3. Do the SRI datapath diagnostics. Refer to Doing the Scan Room Interface (SRI) datapath diagnostics.
  4. Do the PHPS diagnostics. Refer to Doing the Patient Handling Power Supply (PHPS) board level diagnostic.
  5. Perform Check scan.
