Flow meter replacement

Prerequisites

Table 1. Personnel requirements
Required personsPreliminary requirementsProcedureFinalization
1Not Applicable -Not Applicable
Table 2. Tools and test equipment
ItemQuantityEffectivityPart numberManufacturer
Philips screwdriver1---
Flat-blade screw driver1---
Adjustable wrench2---
Gloves1 pair---
Seal tape1---
Water container1---
Table 3. Replacement parts
ItemQuantityEffectivityPart numberManufacturer
Flow meter--

5717574

-
Table 4. Required conditions
ConditionReferenceEffectivity

System Power must be turned OFF. Refer to Lockout / Tagout for System Cabinet PDU Main Breaker

--

About this task

Flow meter (PN#5717574, NITTO-KOHKI FM-03A FM-03B) set up as FRU, which can be used by certain plumbing assemblies listed See . FE can order flow meter instead of entire plumbing assemblyto do replacement.

Table 5. Flow meter on plumbling assemblies
Flow meterPlumbing assembliesDescription
57175745343091PLUMBING ASSY MCS
5343093PLUMBING ASSY - Facility Water
5343094PLUMBING ASSY 2-11kw chiller

Figure 1. Flow meter position on 5343091

Figure 2. Flow meter position on 5343093

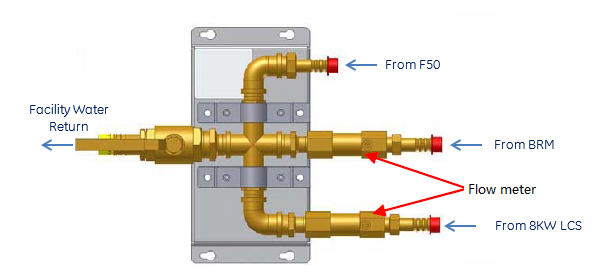

Figure 3. Flow meter position on 5343094
Note:

The flow should flow in the direction of the red arrows.

Built-in flow meter valve should be set in open position.

Procedure

  1. Switch off the valves on plumbing assembly (handle of valve should be perpendicular to hose pipe. Put the water container under the pipe connector since there will be residual cooling water in it.
  2. Loose hose clamp and remove hose pipe from hose nipple of defect flow meter.

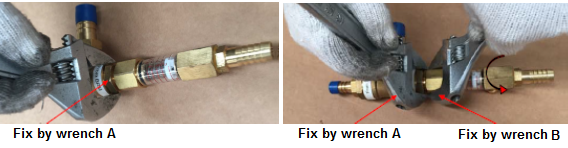

  3. Use wrench A to fix hex connector from tee joint side, and use wrench B to fix hex connector of flow meter. Keep wrench A in original place, then rotate wrench B to remove defect flow meter by anti-clockwise direction turn.

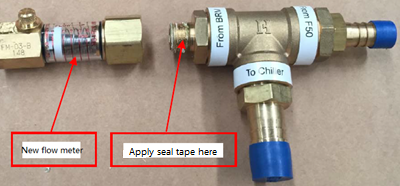

  4. Apply the seal tape on screw thread of tee joint with clockwise direction turn, and then install new flow meter with tee joint together.

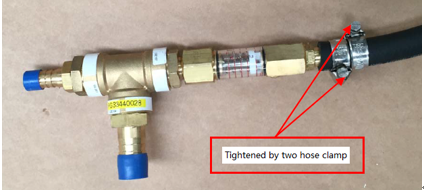

  5. Install hose pipe on hose nipple of new flow meter, then tighten pipe by two hose clamps---one clams was tighten by position turn & another clamps was tighten with inversion turn.
  6. After new flow meter replacement, reassemble the plumbing connection and switch on the valves to check whether there is water leak.
  7. Remove the power lock- out tag-out from the System cabinet and restore power. If water leakage observed, re-perform installation from Step 2step 2

Finalization
